Culverting the Brook 1977
A series of six photographs by A J George of the culverting of the Brook

From Little Street, near the Old Meeting Baptist Church to Duck Street.

map

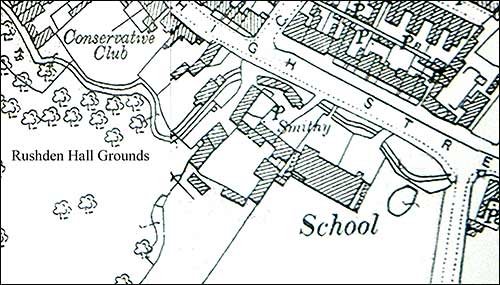

1900 Map showing the brook near the South End School, at the corner of High Street South and Wymington Road.

Next door was Lewis' blacksmiths yard, house and smithy.

The Brook flowed along in front of both and then meandered behind the Conservative Club and into Rushden Hall grounds. A bridge gave access into the school playground.


more about the brook
St. Peter's Parish. This was effected by an Order in Council on December 4th, 1913. The boundaries of the parish are marked by the Hall Brook as it flows along its covered course from the Wellingborough Road, by way of Duck Street. Where this stream meets the railway, the boundary follows the track of the iron road as far as the boundary of Higham Ferrers. From that point it takes a straight line to, and then along the middle of Northampton Road leading to Wellingborough. At a point where a little-used road branches off past the leather factory which is situated- there, the boundary runs down to the River Nene and follows that watercourse as far as the Irchester boundary. Following that new line southward as far as Knuston Spinney, it turns eastward along the course of the stream which tumbles down its track between St. Margaret's Avenue and St. Mary's Avenue, until it joins the Hall Brook. [extract - St Peter's Golden Jubilee programme]

Little street area
Wymington Road area
Little Street - High Street South
High Street South - Wymington Road
Near Townsend's Exit from Hall Park
near Townsend's Garage

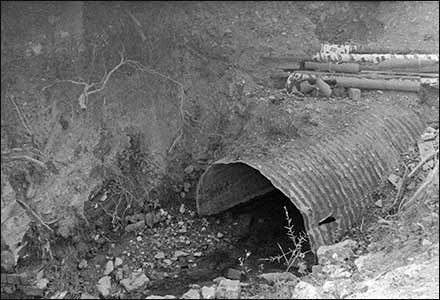

Exit from Hall Park

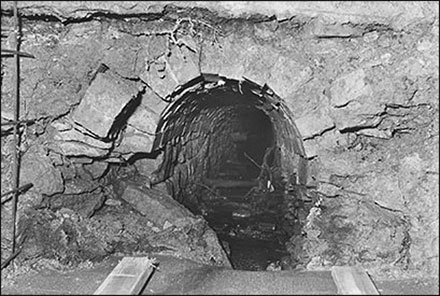

Skinner's Hill sluice
Lightstrung area
Skinner's Hill sluice
Lightstrung area into Duck Street

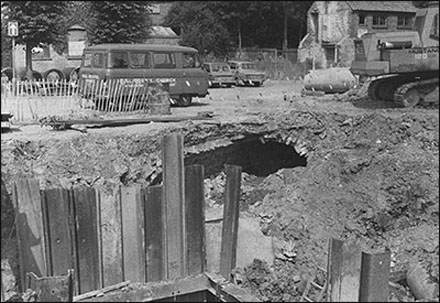

The brook along Duck Street was culverted in 1977 - plan and the report.

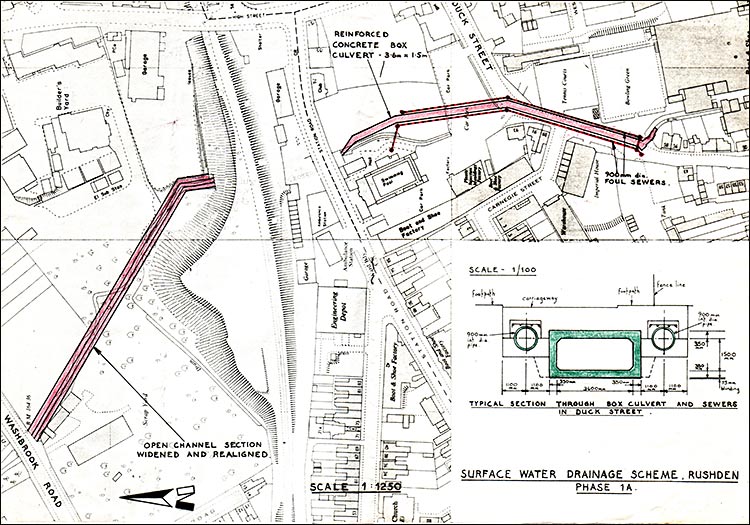

Plan 1977
Plan for the drainage works 1977

Visit of Inspection
To
Rushden Surface Water Drainage Scheme Duck Street

6.30p.m. Monday 2nd May 1977

Main Drainage -Problems
In 1968 severe flooding occurred in Duck Street, College Street, The Lightstrung, Skinners Hill and Mannings Street areas of Rushden with entry of water into residential and industrial premises. The former Rushden Urban District Council commissioned Messrs. L.G. Mouchel & Partners, Consulting Engineers, to carry out an investigation into the capacity of the main surface water drainage system (known as the Town Brook) which is situated in the valley which runs from south-east to north-west through Rushden and to which virtually the whole of the developed area drains.

The Consulting Engineers' report presented in October showed that many sections of the existing surface water system had insufficient capacity to take flows arising from existing development from a storm of an intensity likely to occur at least once a year and flooding was likely to be a frequent occurrence. The Consulting Engineers were instructed to prepare proposals for enlargements to the main surface water system to deal with flows from existing properties and to permit further development in the southern part of the town adjacent to Bedford Road. This entailed a comprehensive investigation of all surface water sewers throughout the town which drained to the Town Brook and in 1972 Mouchel & Partners submitted their second stage report on the necessary works. The report was accepted by the Urban District Council but the proposals to re-organise Local Government throughout England and Wales were then beginning to have an effect, although consultations with Government Departments and other interested authorities continued. About this time, it became apparent that the trunk foul sewers which are situated in the same valley adjacent to the Town Brook were operating at full capacity and surcharging during times of heavy rain.

On 1st April 1974, responsibility for sewerage and sewage treatment passed to the new Anglian Water Authority, but the new East Northamptonshire District Council acts as its Agent for the design, construction and operation of works of sewerage. The 5 Year Programme of Capital Works to be carried out by the Council on behalf of the Water Authority contains three schemes for the improvement of trunk sewers throughout the length of Rushden and these are:-

1. Surface Water Drainage Rushden - Phase 1A, which is the contract at present under construction.

2. Surface Water Drainage Rushden - Phase 2, which will be the completion of all the works necessary to the Town Brook.

3. Trunk Foul Sewers Rushden, which will provide additional capacity to the trunk foul sewers from Bedford Road all the way to the Sewage Treatment Works.

Phase 1A of the Surface Water Drainage Scheme is described in more detail below, and Phase 2 will be amalgamated with the Trunk Poul Sewer Scheme to form one contract with an estimated cost in the region of £1 million. Design work is at present in hand and it is anticipated that construction will commence in November this year.

Surface Water Drainage, Rushden - Phase 1A

This contract consists of the minimum amount of work necessary to replace the most heavily overloaded sections of the system and will give immediate relief to the properties which prior to the works were exposed to the highest risk of flooding. The new reinforced concrete box culvert is 3.6 metres in width and 1.5 metres in height (12 ft. x 5 ft. approx.) and, when Phase 2 has been completed, will be capable of carrying flows arising from a storm of an intensity likely to occur only once every five years. The culvert commences in Duck Street, outside No. 58, where it will pick up the flows from the present open channel system, and then pass through Duck Street, the car park and the Council owned land adjacent to the swimming pool where it will be temporarily connected to the existing culvert underneath Station Road and the railway embankment. At the same time, the enlargement of the adjacent foul sewers is being carried out with the provision of a 900 millimetre (3 ft.) diameter pipe on each side of the box culvert and these will be temporarily connected into the existing foul sewers near the swimming pool. Also included in the contract is the widening and realignment of the open channel system between the railway embankment and Washbrook Road.

The work is financed by the Anglian Water Authority and is being carried out by Kimbell Construction Ltd., Boughton, Northampton. The contract sum is £200,326.03 and completion is expected in October this year.

The scheme was designed by Messrs. L.G. Mouchel & Partners, Consulting Engineers, Bath, working under the direction of the East Northamptonshire District Council's Director of Technical Services.
